Pedestrian Bridges - Cudal and Manildra
Cudal Footbridge
Works for the new Cudal pedestrian bridge have now gone to tender, marking a significant step toward reinstating a valued connection across Boree Creek.

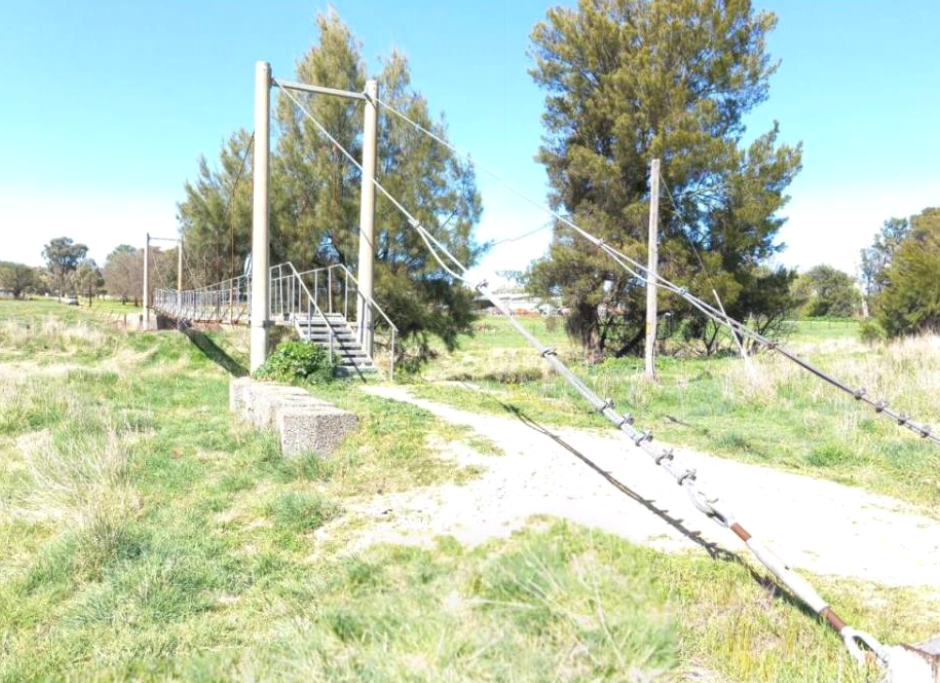

The original Cudal footbridge was a timber suspension structure linking the township with Dean Park via Taylor Street. For many years it provided a safe and convenient pedestrian connection, supported access to local recreational spaces, and served as an alternative route for nearby residents when low-lying crossings, such as Creek Street, were impacted by wet weather or changing creek conditions.
Since its removal, Council has worked with specialist engineers to investigate the site and develop options for a replacement bridge that is safe, accessible and better able to withstand future conditions. Community feedback has also played a key role in shaping the project, with a survey conducted in July 2025 showing strong support for a suspension bridge design, with 62 per cent of respondents selecting this option. The project is focused on restoring this important link for the community while incorporating improved design and resilience.

Manildra Footbridge
In Manildra, Council is also progressing plans to replace the pedestrian footbridge located in Kiewa Street. The bridge was an important part of the town’s local infrastructure, providing a safe and convenient crossing for pedestrians and supporting everyday movement between key areas of the community. Its loss has had a noticeable impact on connectivity within the town.
Since then, Council has been working to restore critical infrastructure and improve resilience across the local government area. The replacement of the Manildra pedestrian bridge forms part of this broader effort, ensuring essential community connections are reinstated and better prepared for future conditions
Funding
Both bridge projects are being delivered with support from government disaster recovery programs. The Cudal Footbridge is funded entirely through the Disaster Recovery Funding Arrangements (DRFA). The Manildra Pedestrian Bridge is primarily funded through the DRFA, with approximately 90 per cent of funding provided through the program and the remaining 10 per cent funded through the Regional Transport Resilience Fund (RTRF), jointly supported by the Australian and New South Wales Governments.
-
Update September 2026
Share Update September 2026 on Facebook Share Update September 2026 on X (formerly Twitter) Share Update September 2026 on Linkedin Email Update September 2026 linkFollowing the award of tenders, Council is preparing to commence works on two new pedestrian bridges.
The Taylor Street Pedestrian Bridge in Cudal will be the first project to begin and is expected to take approximately nine weeks to complete. Following its completion, works will commence on the Manildra Pedestrian Bridge, with construction expected to take approximately 14 weeks.
Following the award of tenders, Council is preparing to commence works on two new pedestrian bridges.
The Taylor Street Pedestrian Bridge in Cudal will be the first project to begin and is expected to take approximately nine weeks to complete. Following its completion, works will commence on the Manildra Pedestrian Bridge, with construction expected to take approximately 14 weeks.
-
Update August 2026
Share Update August 2026 on Facebook Share Update August 2026 on X (formerly Twitter) Share Update August 2026 on Linkedin Email Update August 2026 linkAt the Ordinary Council Meeting held on 28 July, Council resolved to award tenders for both the Manildra and Cudal Pedestrian Bridge projects to a single contractor.
At the Ordinary Council Meeting held on 28 July, Council resolved to award tenders for both the Manildra and Cudal Pedestrian Bridge projects to a single contractor.
-
Update June 2026
Share Update June 2026 on Facebook Share Update June 2026 on X (formerly Twitter) Share Update June 2026 on Linkedin Email Update June 2026 linkThe tender for the design and construction of both pedestrian bridges has now been released, with outcomes expected to be reported to the July 2026 Ordinary Council meeting. These projects represent an important step forward in restoring connectivity, improving safety, and delivering more resilient infrastructure for local communities.
The tender for the design and construction of both pedestrian bridges has now been released, with outcomes expected to be reported to the July 2026 Ordinary Council meeting. These projects represent an important step forward in restoring connectivity, improving safety, and delivering more resilient infrastructure for local communities.
-
Call for Tenders
Pedestrian Bridges - Cudal and Manildra has finished this stage -
July 2026
Pedestrian Bridges - Cudal and Manildra has finished this stageThe tender for the design and construction of both pedestrian bridges has now been released, with outcomes expected to be reported to the July 2026 Ordinary Council meeting
-
August - September 2026
Pedestrian Bridges - Cudal and Manildra is currently at this stageFinal designs prepared for construction and fabrication
-
October - November 2026
this is an upcoming stage for Pedestrian Bridges - Cudal and ManildraFabrication of bridge structures
-
December 2026 - January 2027
this is an upcoming stage for Pedestrian Bridges - Cudal and ManildraSite activities commence including piling and anchor footings
-
February 2027
this is an upcoming stage for Pedestrian Bridges - Cudal and ManildraOpen to public
